Developed and transferred · South West Queensland
Gunsynd Solar PV & BESS
Taken from site selection through development approval, PPA and grid connection, then transferred to Metis Energy.
Project detail
- Generation
- Up to 94 MW
- BESS
- Up to 100 MW
- Grid connection
- Powerlink Bulli Creek 330/132 kV substation
- Transmission line
- Bulli Creek to Waggamba 132 kV
- Owner
- Metis Energy
- Location
- Near Goondiwindi, South West Queensland
Located in South West Queensland near the township of Goondiwindi, Gunsynd Solar Farm will generate up to 94 MW of electricity and up to 100 MW of battery storage that will supply the full township of Goondiwindi and inject into the QLD/NSW electricity grid via the Powerlink Bulli Creek 330/132 kV Substation.
The site received Development Approval in early 2019 after a very co-ordinated and well thought out process with the landowner and local councils.
In November 2022, the project received approval from AEMO and Ergon Energy to connect to the Bulli Creek to Waggamba 132 kV transmission line, and the connection agreement was executed in December 2022.
With the completion of the development approval, PPA, and connection agreement, SkyLab satisfied its obligations under a sale agreement to Metis Energy and ownership transferred.
The Gunsynd Project is a credit to the SkyLab Australia team, and has demonstrated that local industry knowledge with key professionals ensures a great outcome for landowners, community, stakeholders and investors.
SkyLab satisfied its obligations under a sale agreement and ownership transferred.
Development pathway
Milestones.
- Early 2019Development approval, Goondiwindi Regional Council
- Nov 2022AEMO and Ergon Energy connection approval
- Dec 2022Connection agreement executed
- CompletedOwnership transferred to Metis Energy
- Nov 2025Construction completed under Metis ownership
- By 30 Jun 2026Commercial operation anticipated
Independently confirmed
Not just
our word.
Each statement below is drawn from a public document published by a third party, not by SkyLab.
Goondiwindi Regional Council
Decision notice 19/04W names SkyLab Australia Pty Ltd as applicant for the solar farm and battery storage.
Metis Energy (SGX-listed)
Construction completed November 2025, commissioning underway, commercial operations anticipated on or before 30 June 2026.
On site

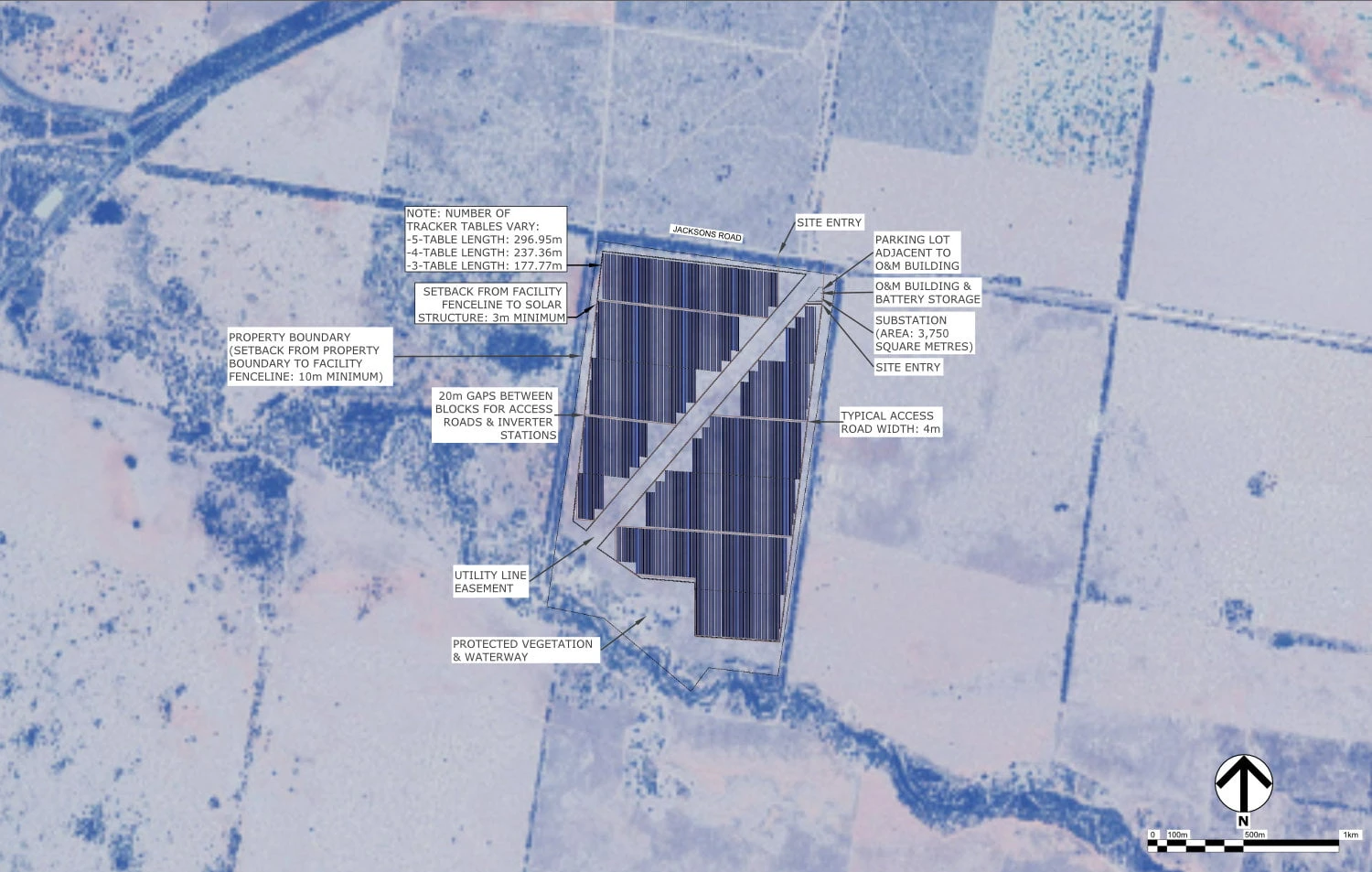

Site layout and approvals
The plans behind it.
